You can use the Tracking Gantt to view the impact that your tracking
information has upon the project schedule. It behaves much like the
Result Gantt except it shows the percent completed for each task.

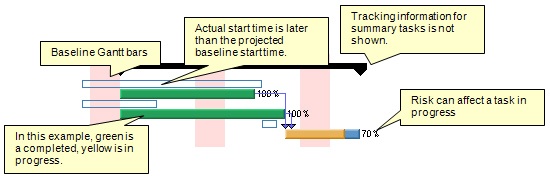

Below is an example of tracking information as shown in the Tracking
view:
RiskyProject uses the following system of colors to represent
percent completed in Tracking and in Result Gantt.
The tracking bars can be turned on and off in the Gantt chart.
Showing the Baseline and Tracking bars
• Right-click on the chart and choose Show Current Schedule
and/or TrackingBars from
the shortcut menu.\\
