Task Simulation Results
RiskyProject allows you to quickly view the cost (revenue, if income
in any task is defined), duration, start time and finish times
uncertainties associated with each task.
After you have completed a probabilistic calculation, you can see
probability that the particular task will start and finish on
certain date, and will have a duration and a cost less than a
certain value. The six charts available are for:
Cost (Revenue)
Duration
Start Time
Finish Time
Variable cost
Work
Viewing Task Simulation Results
1. Right click on a task ID in any view. A shortcut menu opens.
2. Choose Task Simulation Results from the shortcut

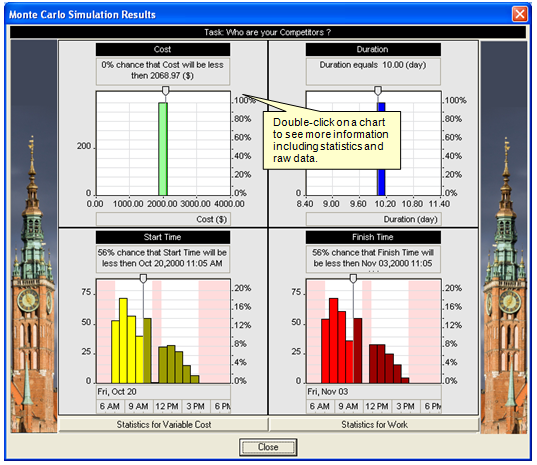

menu. The Monte Carlo Simulation Results dialog box opens.
3. Drag the slider across the charts to view the chance of a certain
result.
4. Double-click on a chart to open up a detailed view of the chart.
Click the tabs on the top of the charts to toggle
between Frequency, Cumulative
Probability views, or their combination.
Click the Statistics, Data,
or Percentiles to view more detailed views of the
result data.
Double click on the frequency chart to
enlarge it
Right-click on a chart to copy the chart, statistics or data
to the clipboard or view cumulative probability, frequency charts,
or their combination.
You may format charts using Options button for short cut
menu. You may use this feature to view task simulation results at
each phase of the project. For example, if you have a milestone
associated with certain phase of the project, you can determine the
chance that this phase of the project will be completed on time and
budget.
See also Task
simulation results details Task
simulation results options
Task
simulation results for cost, revenue, and income
|
